Air Hitam Entrepreneurs'

Site Progress

  • Mitraland

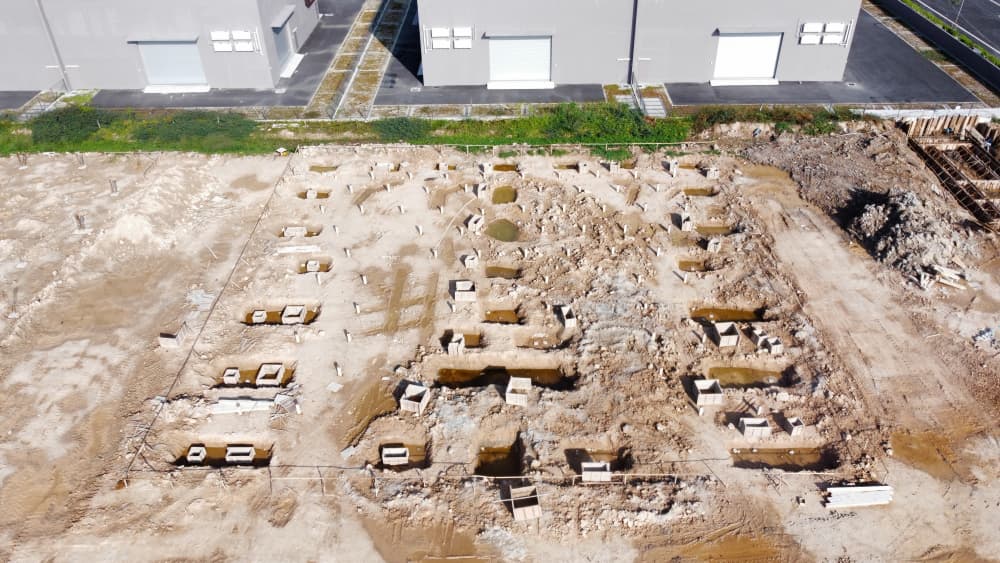

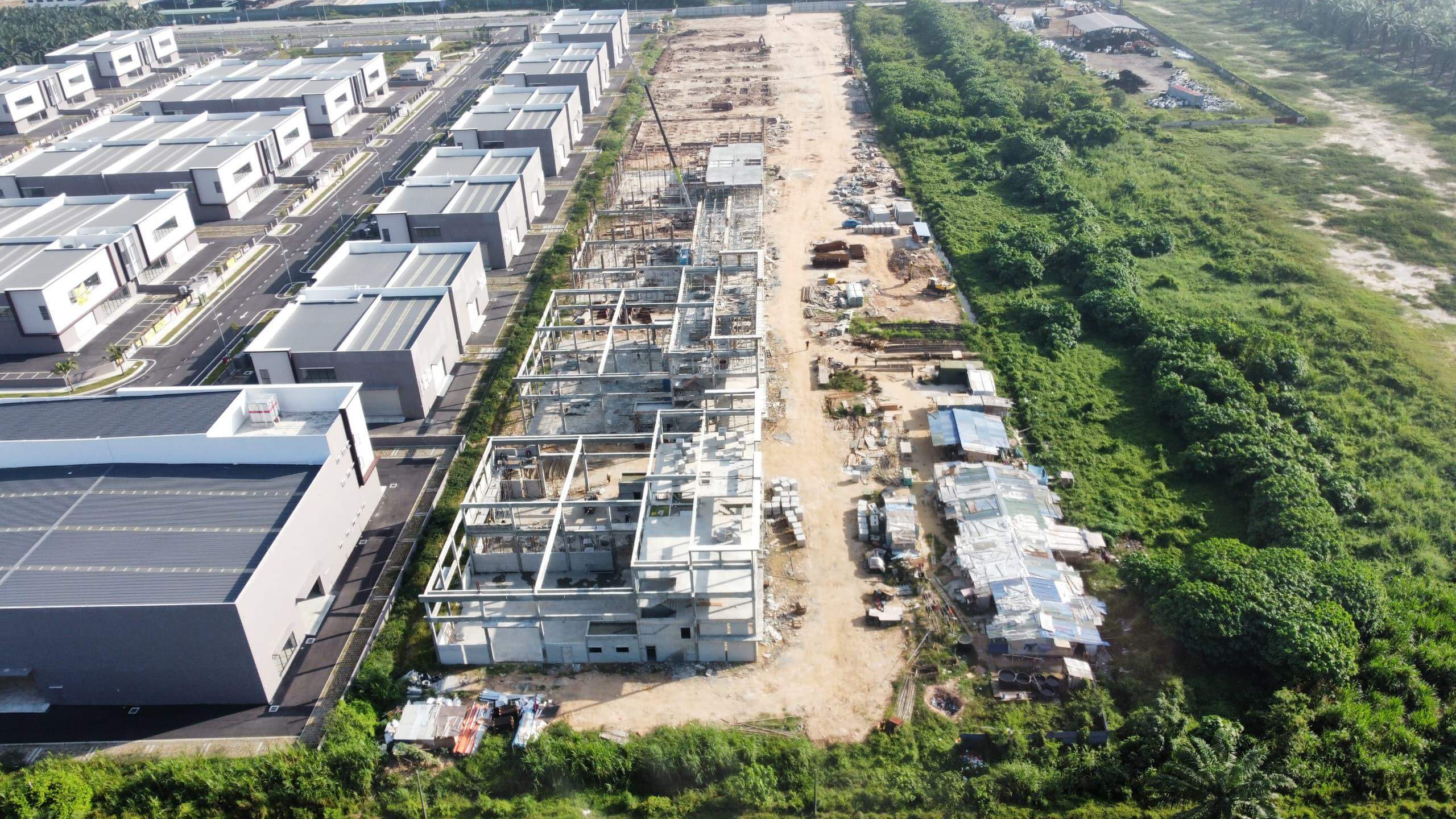

    Apr 2026: Piling Completed

  • Mitraland

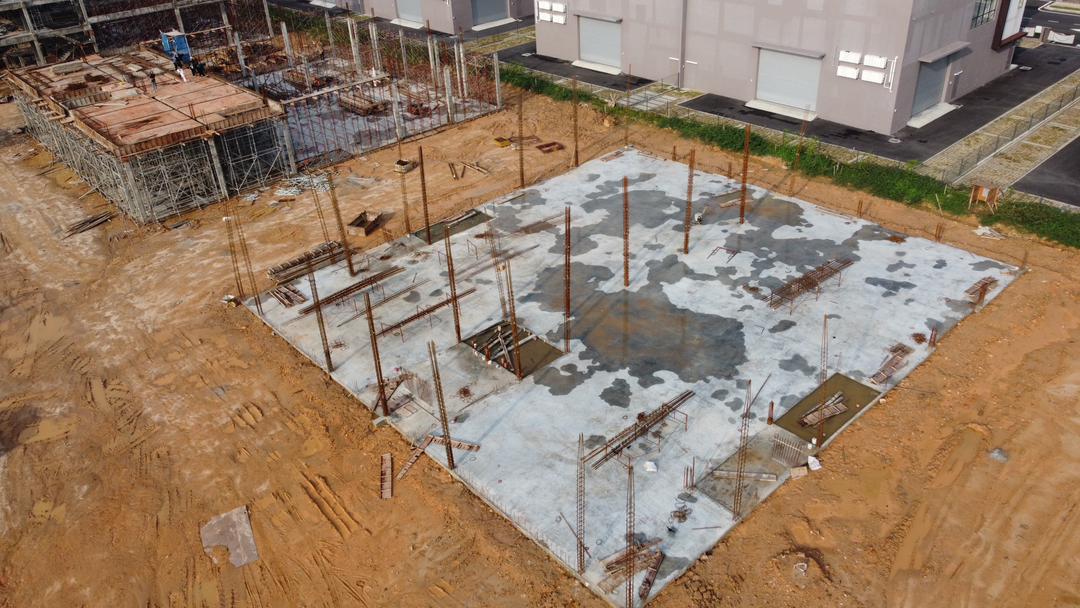

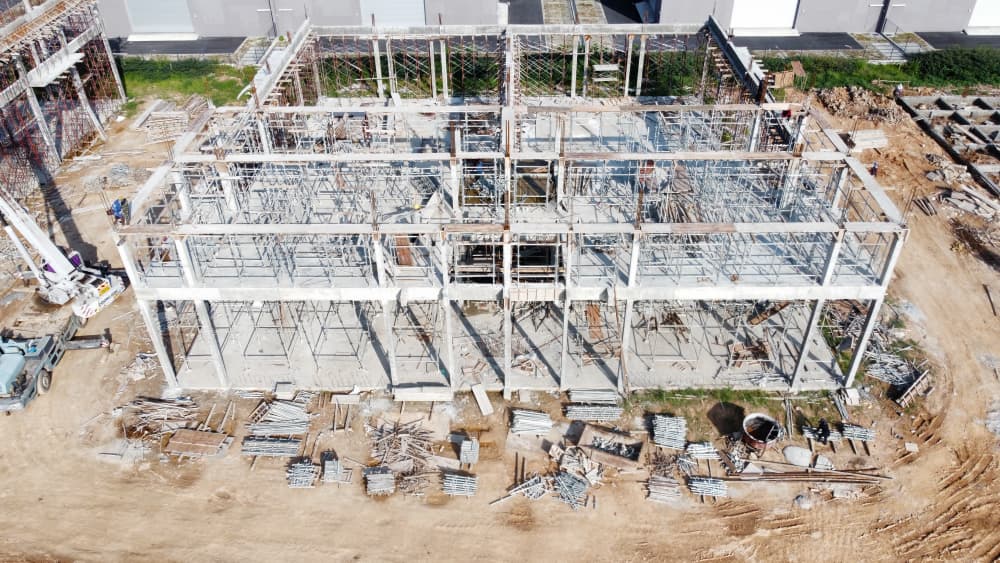

    Apr 2026: Lot 7 & 8 Column in Progress

  • Mitraland

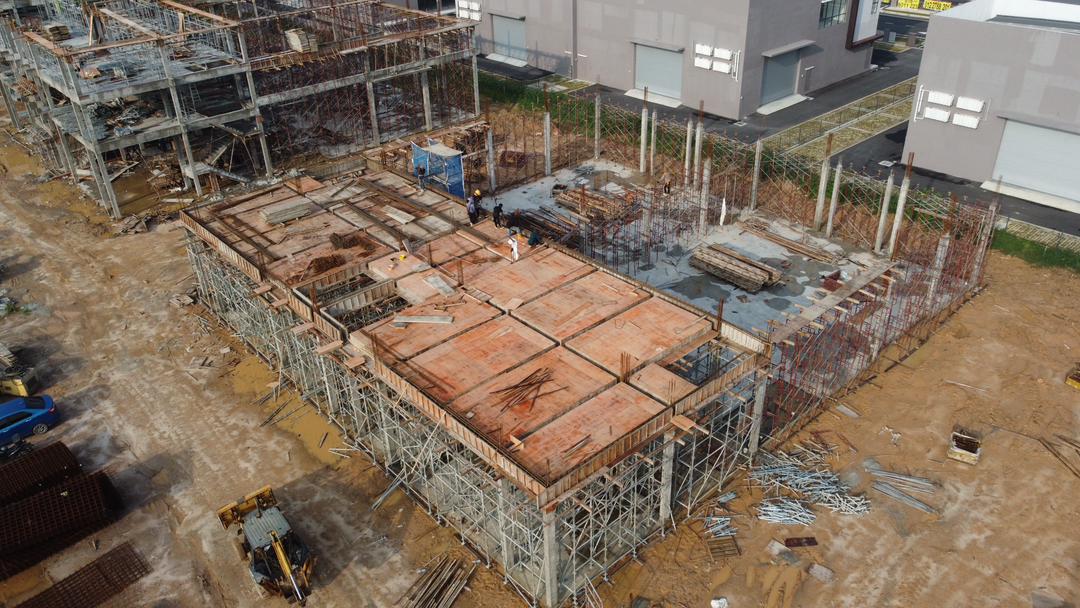

    Apr 2026: Lot 9 & 10 1st Floor Beam and Slab In Progress

  • Mitraland

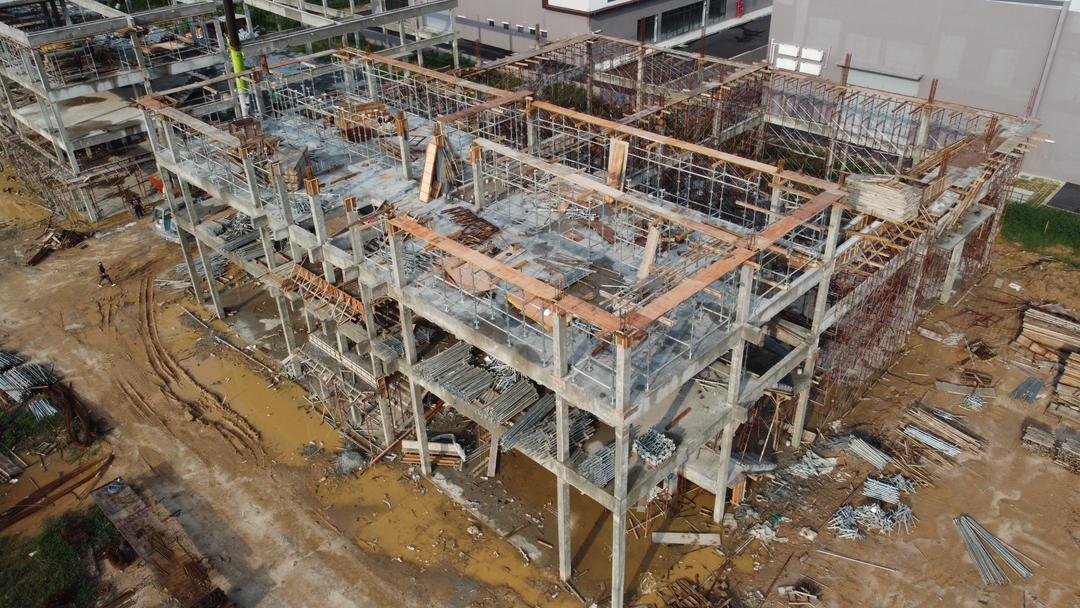

    Apr 2026: Lot 11 & 12 Roof Beam in progress

  • Mitraland

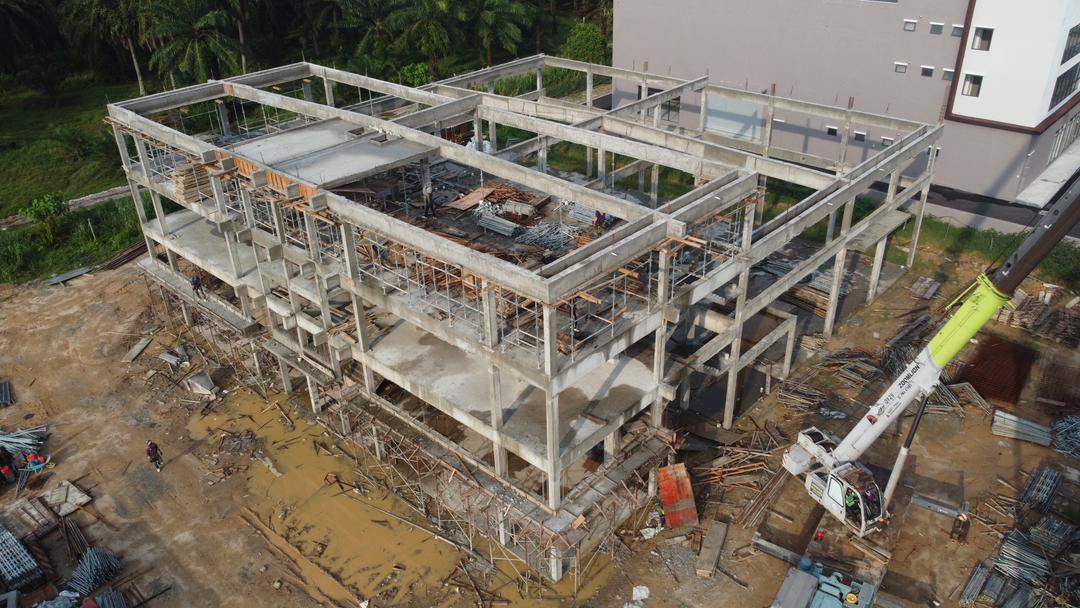

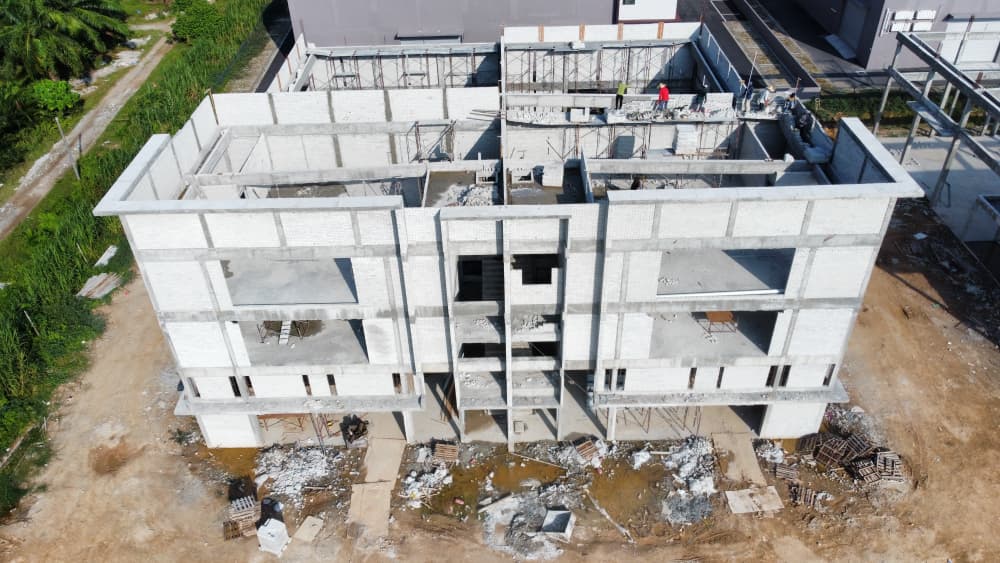

    Apr 2026: Lot 13 & 14 Roof beam and slab completed

  • Mitraland

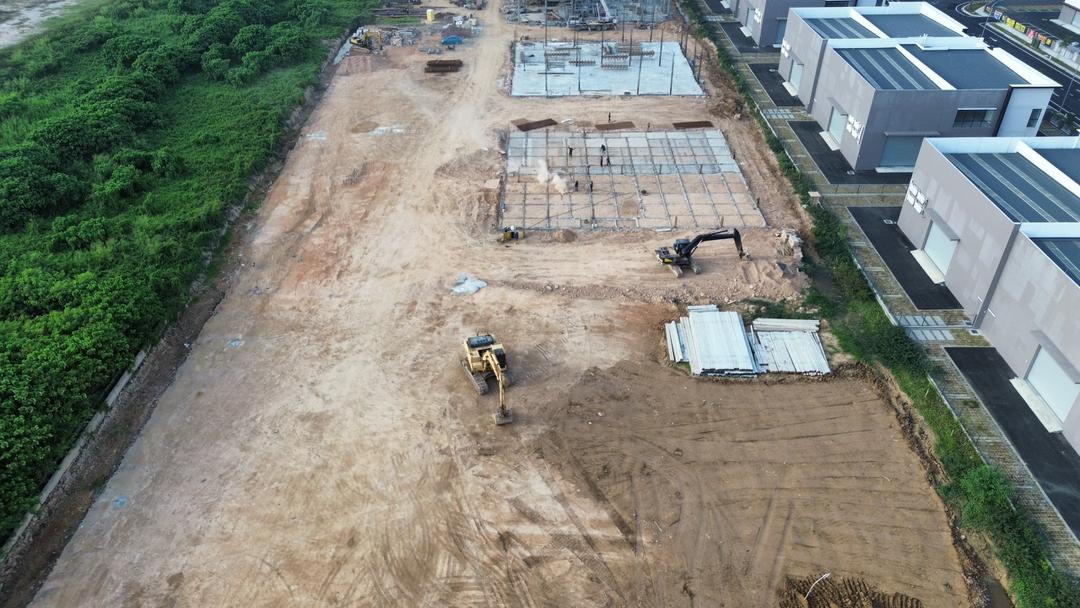

    Mar 2026: Lot 5&6: Removing Surcharge

  • Mitraland

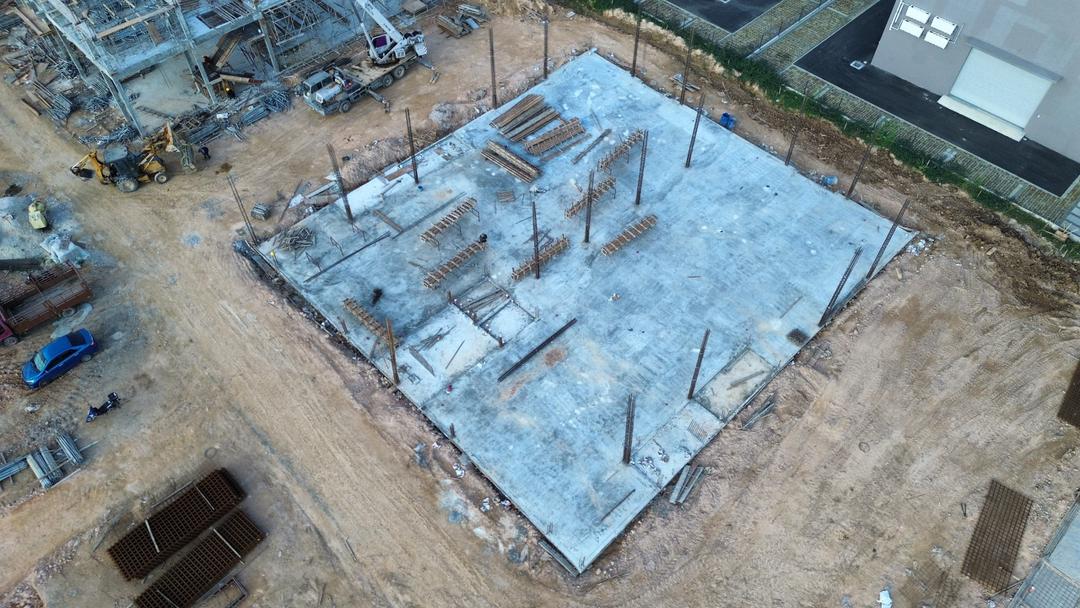

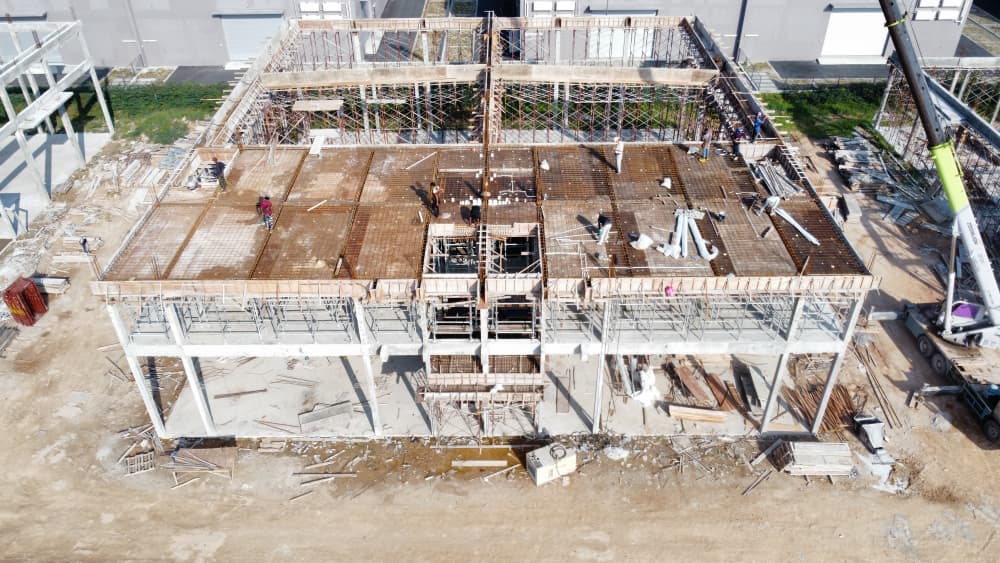

    Mar 2026: Lot 9&10 - Ground Slab Completed

  • Mitraland

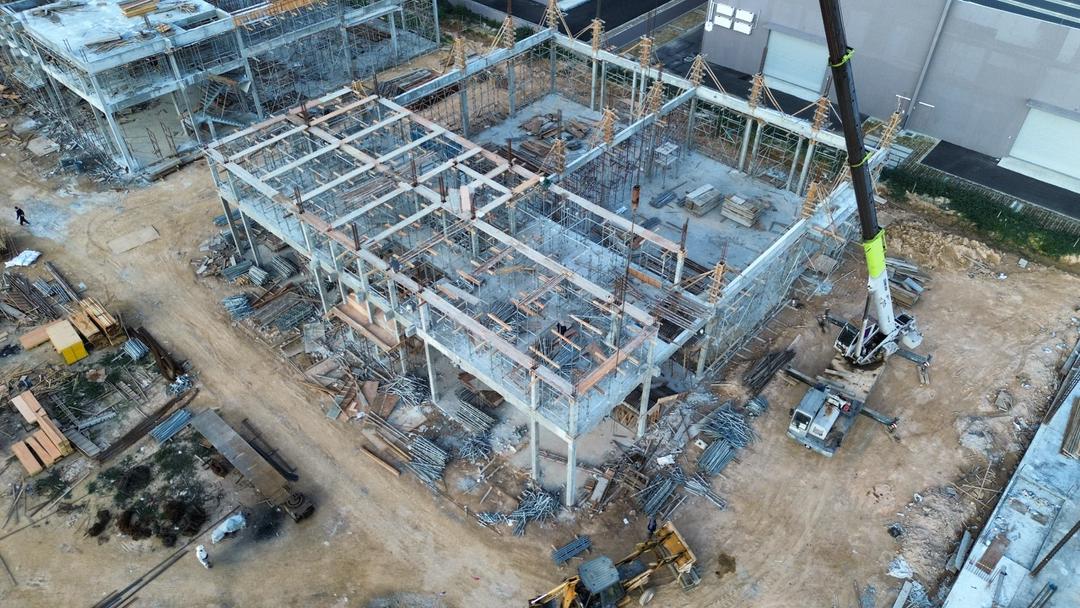

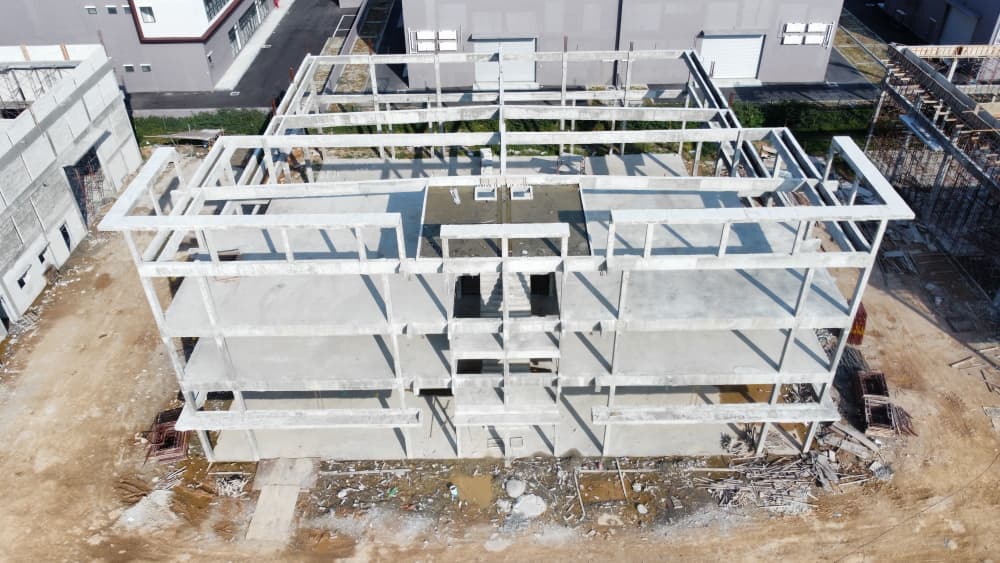

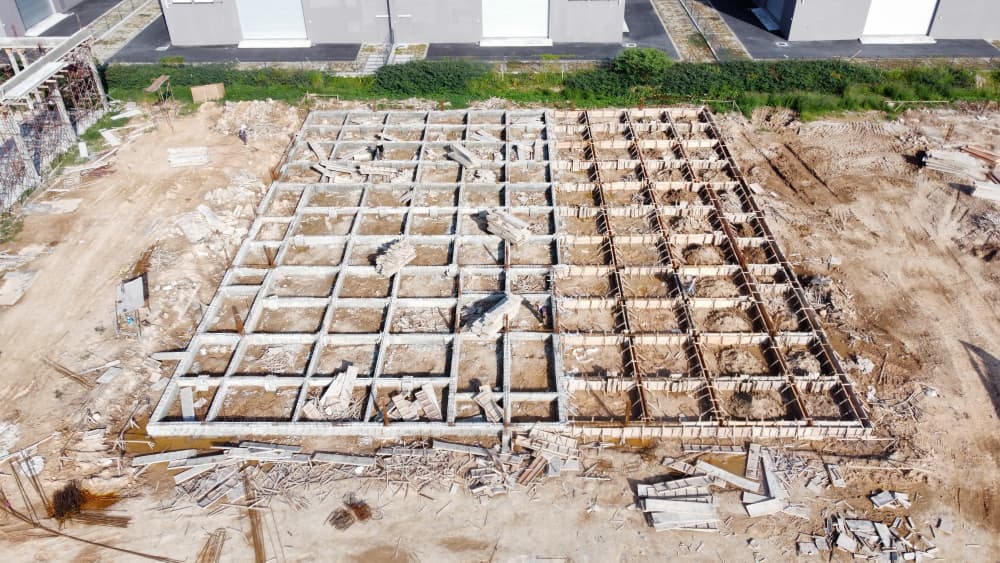

    Mar 2026: Lot 11&12 - 1st Floor Beam Completed

  • Mitraland

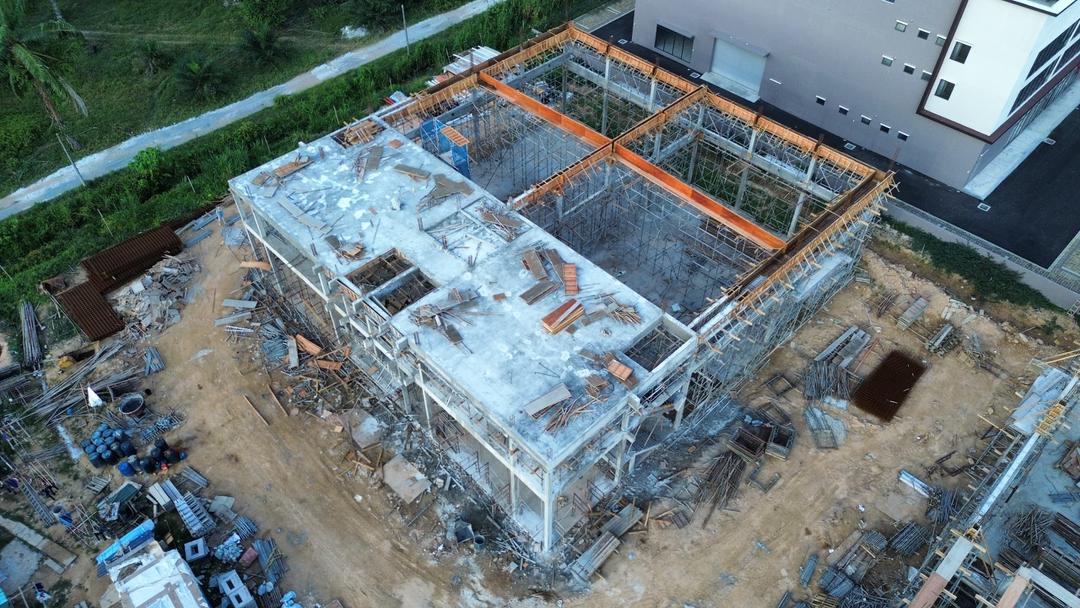

    Mar 2026: Lot 13&14 - 2nd Floor Slab Completed

  • Mitraland

    Feb 2026: Rear View of Air Hitam Lot 8631

  • Mitraland

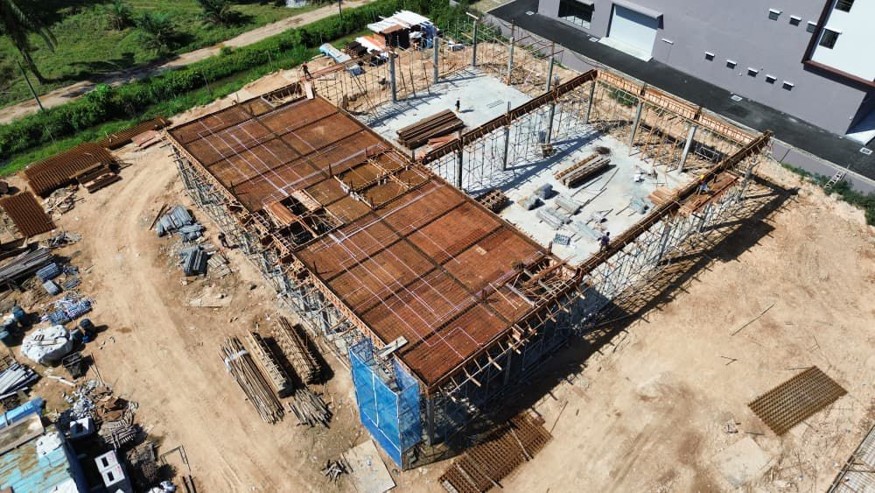

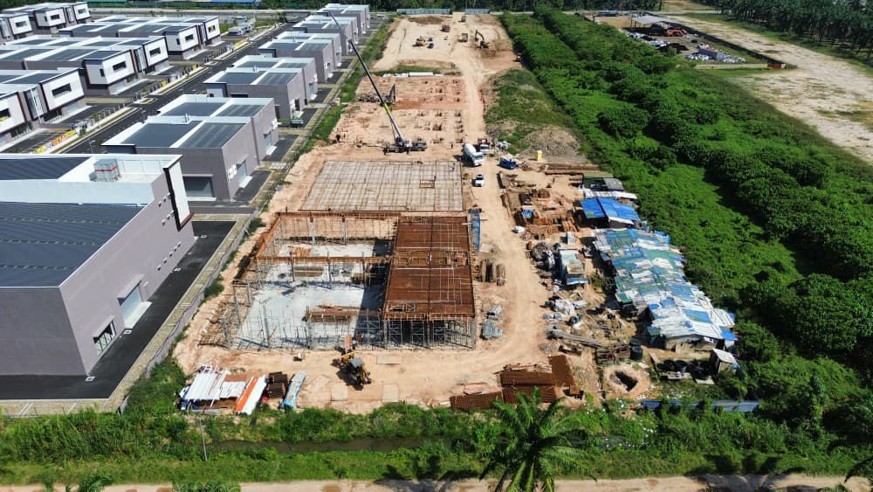

    Feb 2026: 1st Floor Beam & Slab Reinforcement Work in progress

  • Mitraland

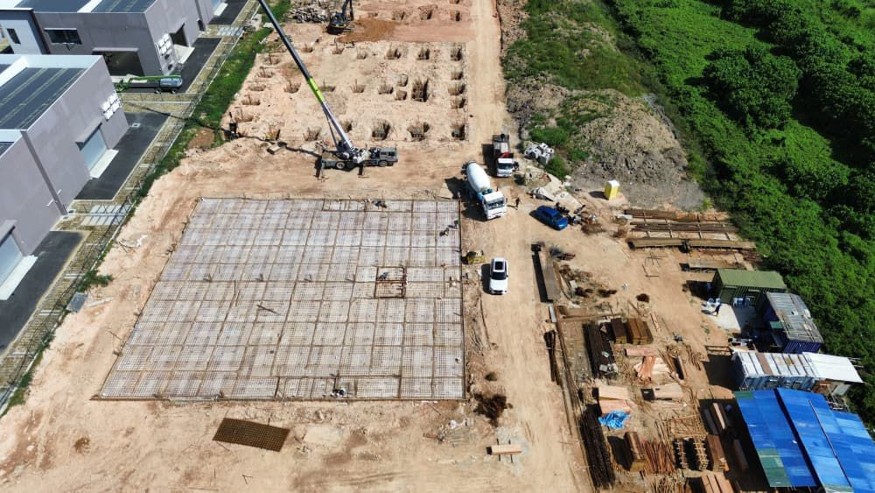

    Feb 2026: Ground Floor Slab Reinforcement Work In Progress

  • Mitraland

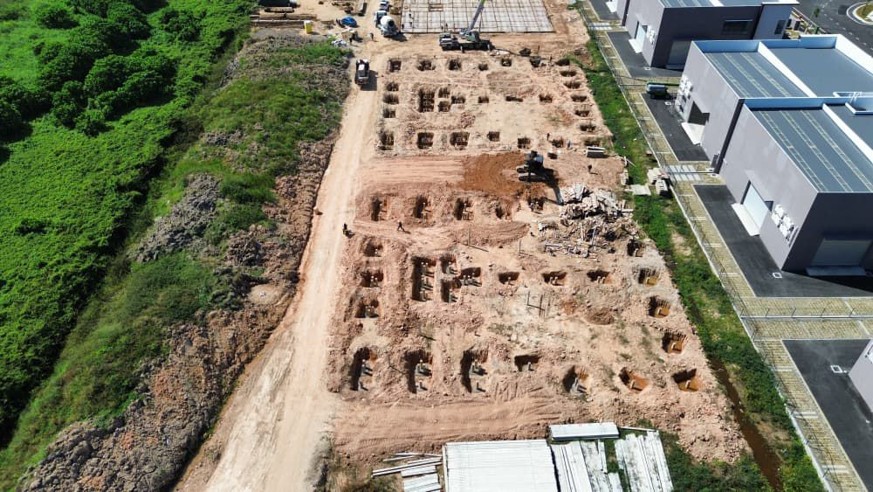

    Feb 2026: Pilecap Excavation Work In Progress

  • Mitraland

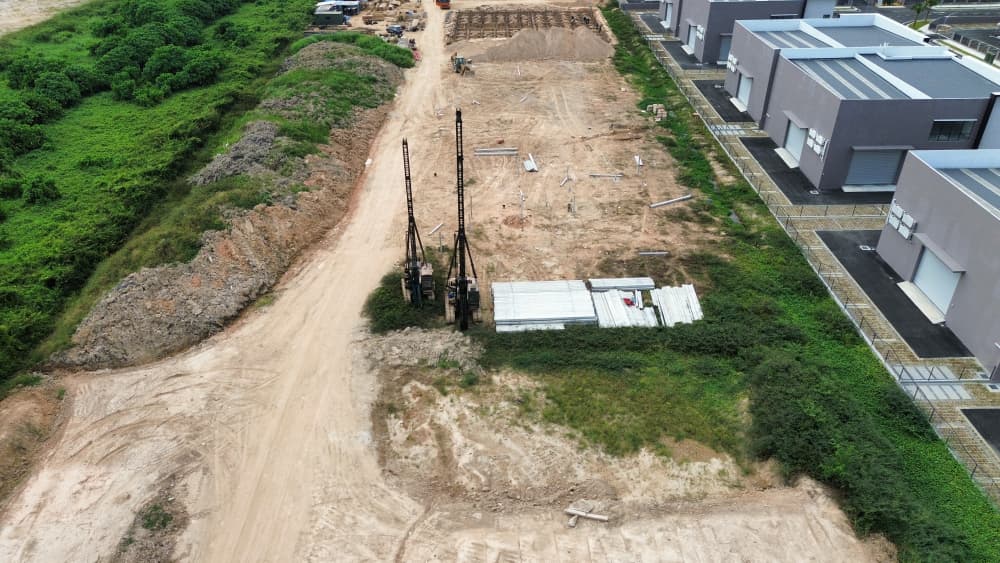

    Jan 2026: Lot 8 and Lot 7: Pilling works in progress

  • Mitraland

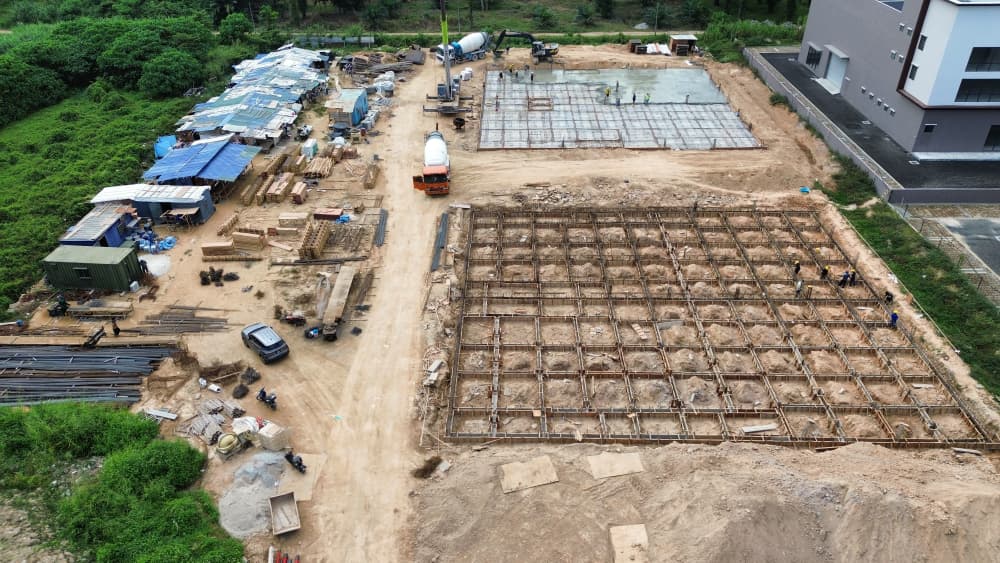

    Jan 2026: Ground Beam Formwork Installation works in progress

  • Mitraland

    1 Aug 2025: Road access & Landscape work in progress.

  • Mitraland

    1 Aug 2025: Road access & Landscape work in progress.

  • Mitraland

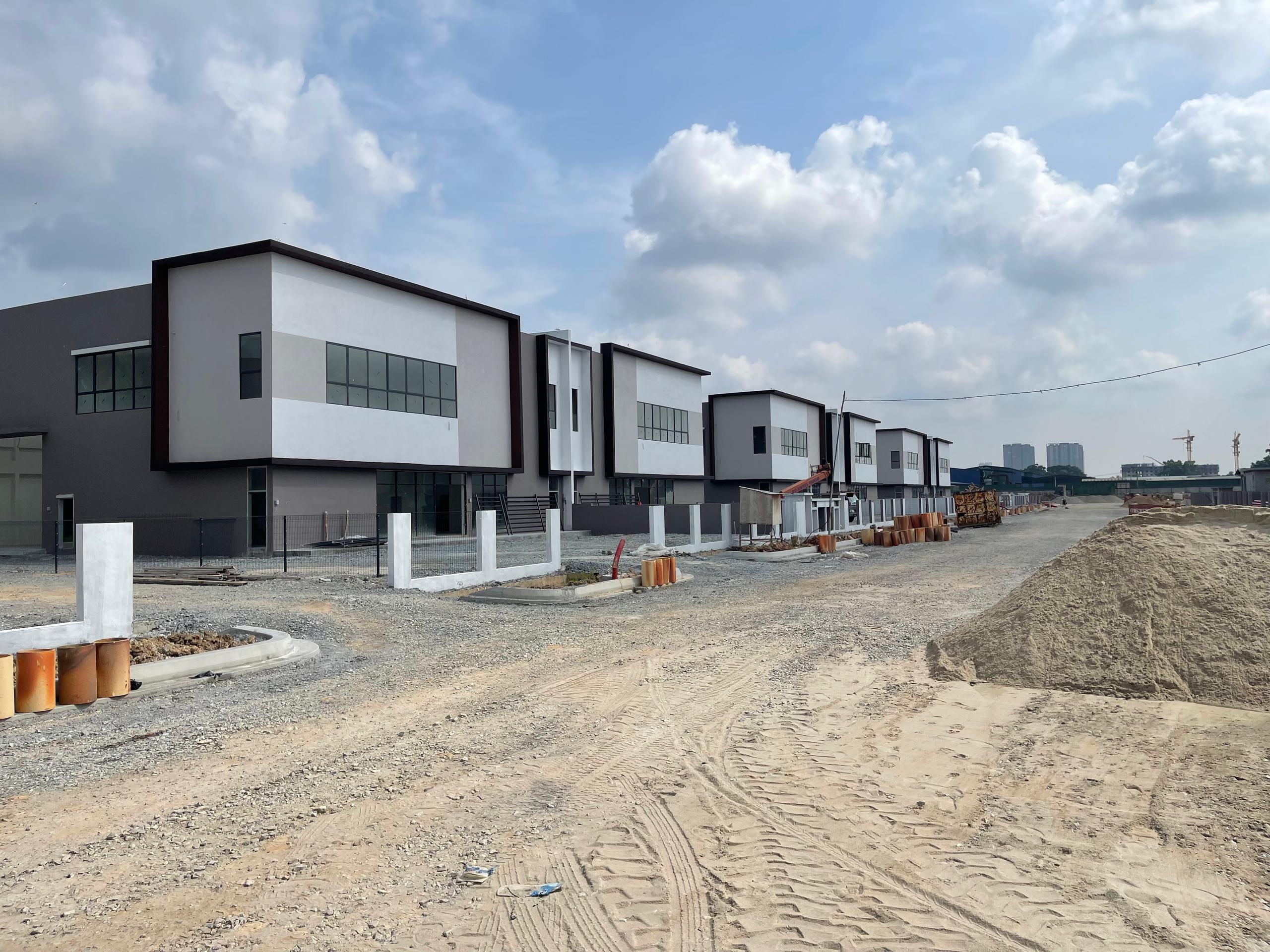

    1 July 2025: Road works in progress.

  • Mitraland

    1 July 2025: Road works in progress.

  • Mitraland

    1 July 2025: Road works in progress.

  • Mitraland

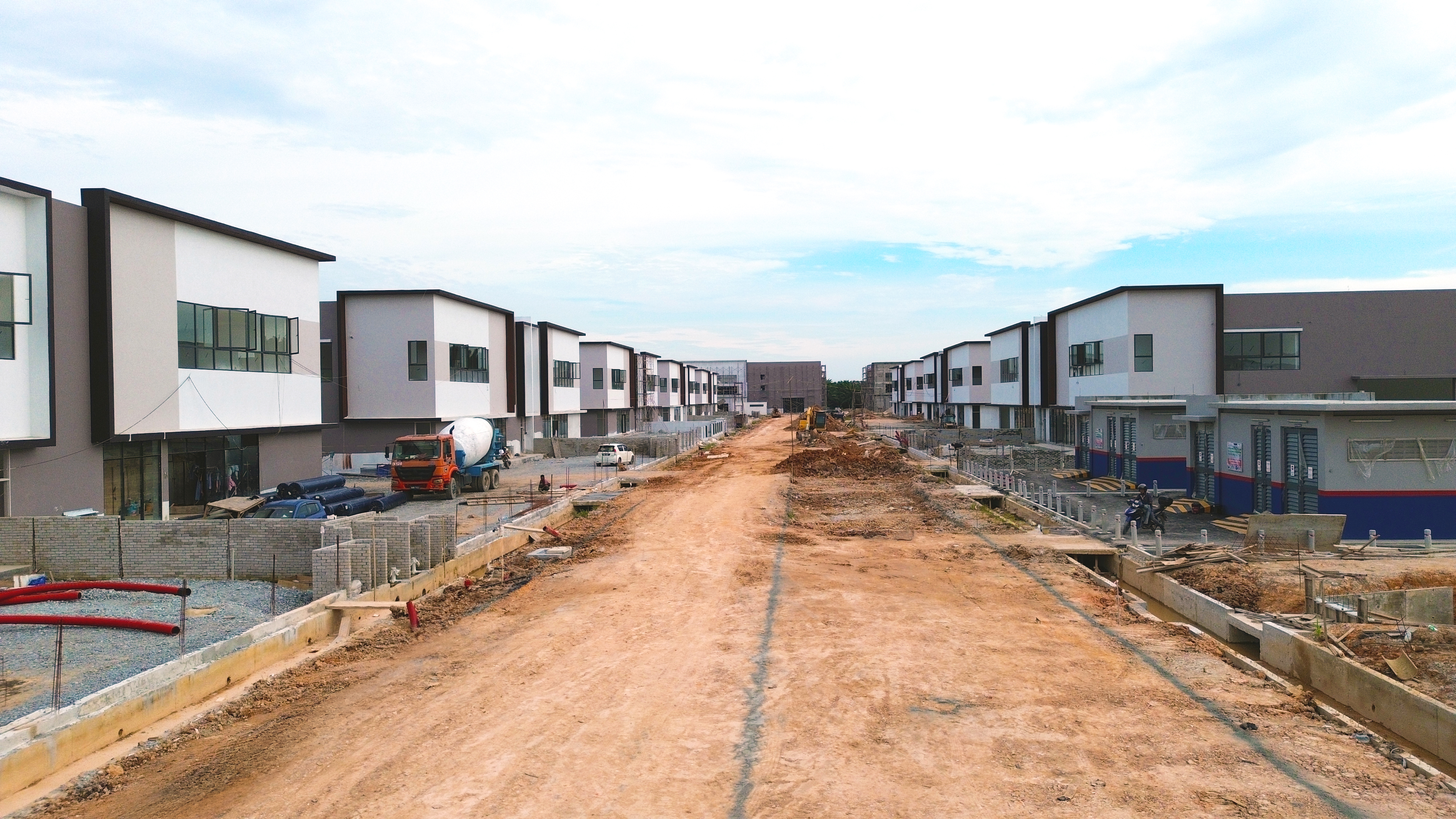

    1 May 2025: Commencement of internal infrastructure works.

  • Mitraland

    1 March 2025: Architectural work in progress.

  • Mitraland

    1 February 2025: Architectural work in progress.

  • Mitraland

    1 November 2024: Architectural work in progress.

  • Mitraland

    1 June 2024: Main building works in progress.

  • Mitraland

    1 January 2024: Surcharge removal in progress.

  • Mitraland

    1 December 2023: Surcharge consolidation resting period.

  • Mitraland

    1 November 2023: Surcharge consolidation & Piling work.

  • Mitraland

    1 September 2023: Earthworks and ground treatment works.

  • Mitraland

    1 August 2023: Earthwork & ground treatment works in progress.

  • Mitraland

    30 June 2023: Earthwork & ground treatment works in progress.

  • Mitraland

    1 May 2023: Earthwork & ground treatment works in progress.

  • Mitraland

    1 April 2023: Platform filling works in progress.
